99 Bishop allen drive

In fall 2019 the CRA purchased the building at 93-99 Bishop Allen Drive in Central Square to preserve it as affordable space for nonprofit social service programs. The building has been home to a range of vital nonprofit programs since 1965. The CRA bought the building upon the request of many tenants in the building. Tenants feared that the extreme cost of real estate in the area would threaten their ability to stay in the building after it was sold on the private market, or to find other suitable space.

In December 2021 the CRA substantially completed a major renovation of the building so that it can serve the Cambridge nonprofit and social service community — and all of their members and program participants — for many more decades.


VIRTUAL GROUNDBREAKING, FROM SPRING 2021

The two videos below served as a virtual groundbreaking as the project kicked off. Learn about the project’s history and the many partners who helped it reach this point, and virtually walk through design renderings of the completed building.

Join the Cambridge Redevelopment Authority to celebrate the start of construction at 99 Bishop Allen Drive in Central Square. Thank you to the many partners and stakeholders who helped this project reach this moment. Once completed, the project will provide energy efficient, accessible, affordable space for nonprofit programs in a restored historic building. Thanks to Silverman Trykowski Associates for the renderings included in the video.

"Walk through" the Cambridge Redevelopment Authority's property at 99 Bishop Allen Drive in Central Square, Cambridge to see what it will look like when renovations are complete. The building's nonprofit tenants will return to newly improved office and program space in fall, 2021. Credit to Silverman Trykowski Associates for provision of this video.

CONSTRUCTION UPDATE

As of December 22, 2021 the building has reached substantial completion, and has received a conditional 90-day permit, with just a few items pending to secure a permanent building and occupancy permit! The building’s nonprofit tenants can now fully return to their spaces.

There are two renovation items that will be completed in the spring once the weather warms: new sidewalks and protective finishes on the main entry canopy.

Also in the first half of 2022, the building will see an installation of solar panels on its roof.

The CRA will host a ribbon cutting ceremony for the major renovation in late winter or early spring 2022. We will publicize that event widely once the date is set.

September - December 2021

  • Elevator installation

  • Dormer panel installation

  • Completion of electrical, fire safety and HVAC

  • Pour and finish front entry ramp and stairs

  • Pour and finish rear courtyard

  • Pave rear parking lot

  • Install covered bike parking

  • Foundation waterproofing

  • Installation of flooring and kitchen finishes

  • Painting

August 2021

  • Complete windows installation

  • Demolition of front entry to prepare for new entrance and ramp

  • Start construction of rear egress courtyard wall

  • Continued sheetrock, electrical, ductwork, sprinkler installation

  • Delivery of some elevator components

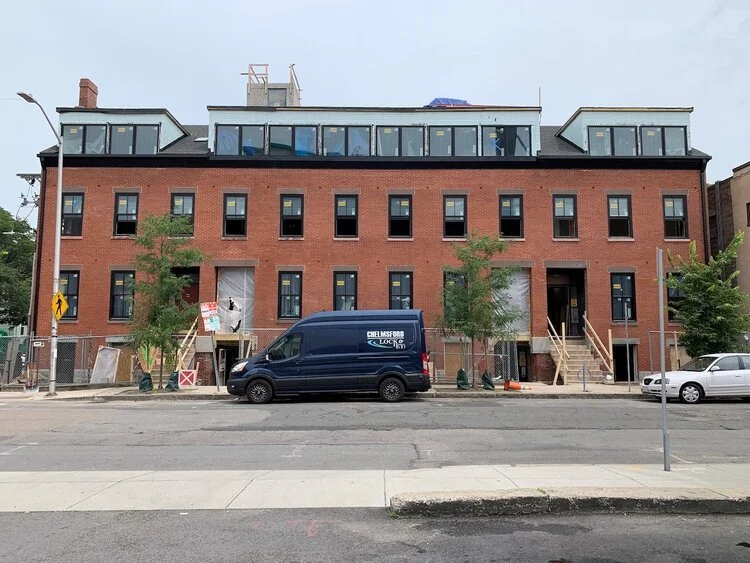

Facade, December 2021

Third Floor Meeting Room

Interior First Floor

Waterproofing interior foundation

Facade, August 2021

Facade, August 2021

July 2021

  • Installation of new windows

  • Continued masonry repair, repointing, and washing

  • New roof installation

  • Fire alarm and electrical wiring

  • Rough plumbing

  • Sprinkler pipe installation

  • Complete mini split and duct work installation

June 2021

  • Removal of improperly buried oil tank discovered on site

  • Continued masonry repair, repointing, and washing

  • Drilling for elevator pit

  • Continued duct work and mini-split installation

  • Continued partition framing and door framing

  • Sprinkler pipe installation

  • Shingle roof demolition

May 2021

  • Installation of stormwater recharge chamber

  • Masonry repointing, washing and lintel installation

  • Rough in of electrical and plumbing

  • Installation of HVAC duct work and mini split units

  • Partition framing

5-2021 Stormwater Chamber Install 2 cropped.jpg

Installation of stormwater recharge chamber

Partitian Walls-page-001.jpg

New plywood subfloor and partition walls

April 2021

  • Targeted interior demolition

  • Asbestos abatement

  • Interior trenching for plumbing and electrical

  • Masonry joint cutting

  • Removal of vinyl siding on dormer

  • Capping and removal of gas service (building will be all electric)

  • Removal of rear parking surface for stormwater drainage system installation

  • Start elevator decommission


March 2021

  • Targeted interior demolition

  • Asbestos abatement

  • Masonry joint cutting


RENOVATION PROJECT

Renovation of 93-99 Bishop Allen Drive is now underway! Tenants will return to the building in fall 2021. The renovations will:

  • Improve HVAC (heating, ventilation, air conditioning) systems

  • Upgrade the fire safety system

  • Improve accessibility and ADA compliance

  • Restore the historic facade

  • Improve energy efficiency, including by installing solar panels

  • Maximize the use of space for social missions

  • Improve the overall quality of the working environment

7-1-20 Request for Community Preservation Act Funds (approved 9/14/20)

5-20-20 Schematic Designs and Renderings

5-20-20 Memo on Bishop Allen Scope, Budget and Timeline

4-15-20 Memo on Possible Project Scope and Design

Below are renderings showing how the building is expected look after renovations are completed in 2021.

Exterior Front View-page-001.jpg
Close Up of Front Entry-page-001.jpg
Conference Room.png

Lower level conference room, with view into kitchenette


PROCUREMENTS FOR RENOVATIONS AND OPERATIONS

Solar EPC (Engineering Procurement and Construction) Contractor

The CRA has engaged Resonant Energy to provide construction management services for a MGL Chapter 149 solar installation project at 99 Bishop Allen Drive. This project is being procured under MGL Chapter 25A using an RFP process. The deadline to apply is July 1st. Please download the RFP from Resonant Energy’s website. Direct questions to Nicole@Resonant.Energy.

General Contractor

G.V.W. Inc. was selected as the general contractor for this project under the process outlined in MGL c.149. The project was electronically bid via www.biddocsonline.com.

1-20-21 Memo Outlining General Contractor Selection Process

Short Term Storage Space

Sterling Corporation was selected as the storage facility during the construction period.

93-99 Bishop Allen Drive Short Term Storage Space RFP Addendum 1

Professional Moving Services

SPRY Moving was selected to move all furniture and equipment out of 93-99 Bishop Allen Drive in advance of the start of renovations and deliver items to a storage facility to be selected in another procurement. We expect to procure moving services to return tenants’ items to the building during summer 2021.

10-21-20 Memo Recommending the Selection of SPRY Moving

93-99 Bishop Allen Drive Moving Services RFP

Commissioning Services

NV5 was selected to provide commissioning services during the construction phase at 93-99 Bishop Allen Drive. They will bring technical expertise to ensure that building systems are designed and installed properly and that they work as intended once the building is completed.

10-21-20 Memo Recommending the Selection of NV5

93-99 Bishop Allen Drive Commissioning Agent RFP

Property Management

TSNE, formerly TSNE Missionworks, was selected as the property manager for the ongoing operations at 93-99 Bishop Allen Drive, starting July 1, 2020. The organization is also providing expertise and feedback during the design phase to support efficient future building operations.

4-15-20 Memo Recommending the Selection of TSNE MissionWorks

Addendum 1 for 93-99 Bishop Allen Facilities Management Services RFP

93-99 Bishop Allen Facilities Management Services RFP

This property was built in 1855 as four elegant row houses. In 1965, the property was purchased by Cambridge Community Services (today called Enroot), renovated, and converted into nonprofit office space.

Today, the CRA owns the site in order to preserve its legacy as a hub in Central Square for vital social services.

In May 2022, the project renovation was awarded a 2022 Preservation Award by the Cambridge Historical Commission.

Nonprofits operating out of the building include:

Boston Area Rape Crisis Center

Brattle Film Foundation

Cambridge Camping

Cambridge Community Foundation

Enroot

Green Cambridge

Next Step

Sustainable Business Network

The Algebra Project

The Loop Lab

The Young People’s Project

Staff and board members of the CRA and Cambridge Community Foundation, as well as staff from the many agencies that run programs in the building, October 2019.

Staff and board members of the CRA and Cambridge Community Foundation, as well as staff from the many agencies that run programs in the building, October 2019.

Fall 2020, a few months prior to the start of renovations.

1970, a few years after the major renovation of 1965.

1970, a few years after the major renovation of 1965.

Corner of Bishop Allen Drive and Essex Street, circa 1930

Corner of Bishop Allen Drive and Essex Street, circa 1930


ACQUISITION

On October 2, 2019, the CRA acquired the property at 93-99 Bishop Allen Drive from Enroot (formerly Cambridge Community Services), the nonprofit who purchased it in 1965. The building is fully occupied by nonprofit organizations, including Enroot, who has transitioned from owner to tenant. Those organizations provide a range of essential community programs. The building’s location in Central Square, very close to public transportation, as well as other characteristics of the site, make it uniquely important as a site for social services.

Tax exempt bond financing for the acquisition was provided by Cambridge Trust and MassDevelopment. In 2020 - 2021, the CRA will also invest at least $2 million in life safety and accessibility renovations, and perhaps other upgrades that will emerge from feedback the CRA will gather from current tenants. Renovations will meet the needs of current tenants but will be universal enough to accommodate future turnover. Once renovations are complete, the CRA will sustain this property over the long term in order to provide affordable space for social service and nonprofit programs.


PUBLIC DISCLOSURE FOR PURCHASE OF REAL ESTATE

Under MGL Chapter 30B, the CRA was required to disclosure its intent to purchase unique real estate at least 30 days prior to executing a binding agreement to acquire property. Data from the first document below was published on the MA Central Registry on June 26, 2019. The second document is being made available on this website as of June 26th, 2019 in order to provide more detailed information relating to this public disclosure.

Real Property Form 3 Posted to Central Register

Additional Explanation Regarding Unique Property


Owner’s Project Manager

STV|DPM was selected as the CRA’s Owner’s Project Manager (OPM) to provide construction expertise for the renovation project, from the design phase through completion of construction.

4-15-20 Memo Recommending the Selection of STV|DPM

Addendum 1 for 93-99 Bishop Allen OPM RFQ

93-99 Bishop Allen Owner’s Project Manager RFQ

Designer

Silverman Trykowski Associates was selected as the designer/architect for the renovation project.

12-18-19 Memo Recommending the Selection of Silverman Trykowski Associates

Addendum 1 - 93-99 Bishop Allen Drive

93-99 Bishop Allen Drive RFQ
